MV Switchgear for BESS: Duty Classes, Inverter Fault Current & Spec Guide

14 min read
NAIJI Electric Engineering
BESS switchgearmedium voltage switchgear battery energy storagebattery energy storage switchgear
MV Switchgear for BESS: Duty Classes, Inverter Fault Current & Spec Guide
Table of Contents

Quick Answer: BESS Breaks Two Assumptions Baked Into Every Catalogue

Medium-voltage switchgear catalogues were written for distribution networks. Two unstated assumptions run underneath every rating table in them, and battery energy storage violates both.

Assumption one: the breaker rarely operates. A utility feeder breaker might open and close a few dozen times a year. IEC 62271-100 mechanical endurance class M1 is 2,000 operating cycles, which on a feeder is several human lifetimes. A BESS breaker tied to daily transformer energisation plus dispatch for grid services accumulates 700-1,500 operations a year. M1 is consumed in two to three years.

Assumption two: a fault draws enormous current. Protection philosophy for distribution assumes a source that delivers roughly 5-20 times rated current into a fault, so overcurrent elements can be set well above load and still see faults instantly. An inverter-based power conversion system is current-limited by its own control firmware to approximately 1.1-1.5 times rated, and it holds that limit. Set a conventional overcurrent element on the BESS side of the transformer and it will never pick up.

Everything else in this guide follows from those two sentences. The comparison table below is the short version.

ParameterConventional distribution feederBESS collection circuitConsequence
Operations per year~10-50~700-1,500M2 (10,000 ops) not M1 (2,000)
Fault current from the source5-20 x rated (synchronous)1.1-1.5 x rated (inverter)Overcurrent alone is inadequate
Power flow directionOne wayBidirectional, reverses dailyDirectional elements, non-directional backup
Typical switching dutyLoad and fault currentUnloaded transformer + long cableCapacitive duty, C2 restrike class
Harmonic contentLowPCS switching harmonicsBusbar derating, CT accuracy at harmonics
StaffingOften attended substationUnattended, remote siteFull SCADA, condition monitoring, IAC rating

Where the Switchgear Sits in a BESS

The electrical architecture of a grid-scale battery site is remarkably consistent regardless of vendor, which makes the switchgear scope easy to define once you can see it.

LevelVoltageEquipmentFunction
Battery racks800-1,500 V DCDC breakers, fuses, contactorsString protection and isolation
Power conversion system (PCS)400-690 V ACLV switchgear / integratedDC-AC conversion, grid forming or following
Step-up transformer0.69 / 12-36 kVTransformer + MV switch or breakerVoltage step-up, galvanic separation
MV collection12-36 kVMetal-enclosed / metal-clad / RMUAggregate PCS blocks onto a collector bus
Point of connection33-132 kVMetal-clad, GIS or AISUtility interface, metering, protection

Two switchgear decisions dominate the cost and the risk: what protects each PCS transformer, and what forms the collector bus. On smaller sites a compact ring main unit per PCS block is common, because it is sealed, outdoor-capable and needs no maintenance. On larger sites the collector bus is a metal-enclosed or metal-clad assembly in a dedicated e-house, with a breaker per feeder so that a single PCS block can be isolated without curtailing the site.

The economically important question is whether each PCS transformer gets a load-break switch with fuses or a circuit breaker. Fuses are cheaper and faster on high fault currents. But they are single-use, they cannot be operated remotely, they are prone to single-phasing, and — decisively for a BESS — they will not see an inverter-side fault at all, because a fuse needs many times rated current to melt in a useful time and the inverter refuses to supply it. For anything beyond a very small site, put a breaker on each PCS transformer.

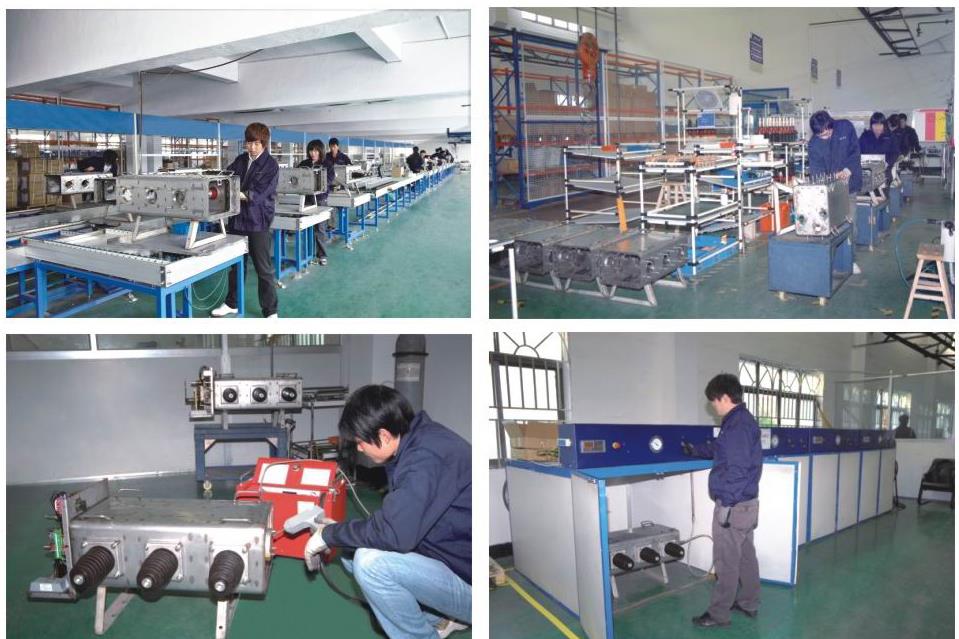

Routine testing of medium voltage circuit breakers destined for battery energy storage collector switchgear
Routine testing before dispatch. On a BESS the same breaker design is asked to operate two orders of magnitude more often than on a distribution feeder.

The Duty-Cycle Arithmetic Nobody Runs

This is the single calculation that separates a BESS specification from a copied distribution specification, and it takes under a minute.

Count the operations. A conservative baseline is two operations per day — one to energise for the charge window, one for the discharge window — which is 730 operations per year. A site doing two arbitrage cycles a day plus responding to frequency-regulation dispatch signals can easily reach 1,500. Now compare against the endurance classes.

IEC 62271-100 classRated operating cyclesYears at 730 ops/yrYears at 1,500 ops/yrVerdict for BESS
M1 (standard)2,0002.7 years1.3 yearsUnusable
M2 (extended)10,00013.7 years6.7 yearsMinimum acceptable
Vacuum contactorCommonly 100,000+137 years67 yearsWhere switching, not fault clearing, dominates

Class definitions per IEC 62271-100: M1 = 2,000 operating cycles, M2 = 10,000 operating cycles. Years shown are rated endurance divided by assumed annual operations, before any maintenance interval.

Read the M2 row against a twenty-year project life. Even M2 does not comfortably cover a hard-cycling site for the full term — it covers most of it, and the remainder is a planned mid-life overhaul rather than an unplanned failure. That is a legitimate commercial position, but it has to be a decision rather than a surprise in year seven.

Where a circuit switches constantly but rarely has to clear a fault — for instance a dedicated switching duty behind a separate protective device — a vacuum contactor rated for 100,000 or more operations is the correct component and is considerably cheaper than a breaker. Using a breaker as a contactor is a common and expensive mistake on cycling assets.

Why Inverter Fault Current Changes Your Protection

A synchronous machine faulted at its terminals is a physical object obeying physics: flux is trapped in the rotor, and current surges to many times rated before decaying. An inverter is a software-defined current source. When its output current reaches the limit written into its firmware — typically 1.1 to 1.5 pu, occasionally up to 2 pu for a brief window on grid-forming units — it stops increasing, regardless of how low the voltage goes. Many units will then ride through for a defined period and trip on their own internal protection.

Consequences for the protection scheme:

  • Instantaneous overcurrent (50) set above load current will not operate for a fault fed from the BESS side. There is no current step change large enough to distinguish fault from load.
  • Time overcurrent (51) becomes marginal. A pickup low enough to see 1.2 pu is uncomfortably close to legitimate full-output operation.
  • Directional elements (67) are essential, because power flows both ways depending on time of day, and a non-directional scheme cannot tell an export from a fault-direction reversal.
  • Voltage-restrained or voltage-controlled overcurrent (51V) is a practical answer: it lowers the pickup when voltage collapses, letting a modest current look like a fault when it is accompanied by depressed voltage.
  • Undervoltage (27), overvoltage (59), over/underfrequency (81O/81U) and rate-of-change-of-frequency carry more of the detection load than they would on a conventional feeder, and their settings are usually fixed by the utility's grid code rather than by you.
  • Differential protection (87T on the transformer, 87B on the bus) is the most reliable answer where the budget allows, because it does not depend on fault current magnitude at all — it depends on current going in not matching current coming out.
ANSI functionRole in a BESSPriority
87T / 87B — differentialMagnitude-independent; the backbone of BESS protectionHighest
67 / 67N — directional overcurrentHandles daily flow reversalHigh
51V — voltage-restrained overcurrentSees inverter-limited faults during voltage collapseHigh
27 / 59 — under/overvoltageGrid-code compliance and islanding detectionHigh (mandated)
81O / 81U / 81R — frequency and RoCoFAnti-islanding, grid-code complianceHigh (mandated)
50 / 51 — instantaneous and time overcurrentStill needed for grid-side faults; inadequate aloneMedium
50BF — breaker failureUnattended site, slow response timeMedium-high
49 — thermal overloadContinuous full-output operation is normal here, not exceptionalMedium

Capacitive Switching Duty and Why C2 Is Not Optional

The typical BESS switching event is not a fault. It is energising or de-energising a step-up transformer that is unloaded or lightly loaded, sitting behind a collector cable that may run several hundred metres. Electrically that is a capacitive circuit with an inductive load behind it — the exact condition in which a restrike traps charge and escalates the voltage.

IEC 62271-100 classifies breakers for this as C1 (low restrike probability) or C2 (very low restrike probability), verified by type test. On a distribution feeder switched twenty times a year, C1 is defensible on probability grounds. On a BESS breaker switched a thousand times a year for twenty years, the same per-operation probability produces a very different expected number of events.

The load on the other side is a transformer feeding an inverter with an output filter — components with limited tolerance for repetitive fast-front overvoltage. This is the same physics we cover in detail in our guide to vacuum breaker switching transients and surge protection, and the same mitigation applies: specify C2, and consider surge protection at the transformer terminals where the cable run is short.

Environment, Layout and the Things That Bite Late

BESS sites are unusual environments for switchgear and several of the resulting problems only surface at commissioning or later.

  • Thermal environment. Sites are frequently in deserts, on industrial land with no shade, or inside containerised e-houses where HVAC is sized for the relays rather than the busbars. Rate for the real internal ambient, not the site ambient, and derate the continuous current accordingly.
  • Condensation. Unattended sites with day-night temperature swings and de-energised panels overnight are close to a worst case for condensation. Anti-condensation heaters are not an option to be value-engineered out; see our guide to switchgear condensation and IEC TS 62271-304.
  • Altitude. Many storage projects land on cheap high-ground sites. Above 1,000 m the dielectric withstand must be derated — the arithmetic is in our altitude derating guide.
  • Internal arc venting direction. Confirm where the pressure relief discharges. On a congested BESS site an arc duct can easily be pointed at a battery container or a walkway during layout.
  • Auxiliary supply. The station battery and charger for trip supply are a genuine single point of failure on an unattended site. Specify supervision of the trip circuit and of the DC supply, and reported to SCADA.
  • Future expansion. Storage sites get expanded far more often than distribution substations do. Buying a collector bus with two spare cubicles and spare bus capacity is cheap now and nearly impossible to retrofit later.

Copy-Paste Specification Clauses

"Medium-voltage switchgear supplied for this battery energy storage facility shall comply with IEC 62271-200, with internal arc classification IAC AFLR at the project fault level for 1 s, and the pressure-relief discharge path shall be shown on the general arrangement drawing and shall not discharge towards any walkway, battery enclosure or access route.

Circuit breakers in the cycling path shall be classified to IEC 62271-100 as mechanical endurance class M2, electrical endurance class E2, and capacitive-switching restrike class C2. The Supplier shall state the rated number of operating cycles and the recommended maintenance interval in operations, not in years.

Protection shall include transformer differential (87T), directional overcurrent (67/67N) and voltage-restrained overcurrent (51V) in addition to the grid-code mandated voltage and frequency elements, and shall be demonstrated by the Supplier to operate correctly for a fault fed exclusively from the inverter-based source at a current-limited contribution of 1.2 times rated.

Current transformers shall maintain their declared accuracy class in the presence of harmonic content representative of the specified power conversion system. Continuous current rating shall be declared at the maximum internal enclosure ambient temperature, not at 40 degC site ambient."

The third paragraph is the one that changes behaviour. Asking a supplier to demonstrate operation at a 1.2 pu current-limited contribution forces the protection study to be done against the real source characteristic rather than against a default utility source impedance.

Procurement Checklist

ItemWhat to confirmWhy it matters here
Endurance classesM2 and E2 stated on the type test report, not just the quotationM1 is exhausted in 2-3 years of cycling
Restrike classC2 for any breaker switching a transformerThousands of capacitive operations over project life
IAC classificationAccessibility types and tested kA / durationUnattended site, slow emergency response
Protection functions87T, 67, 51V present in the relay model quotedOvercurrent alone cannot see inverter faults
CT accuracyClass maintained with PCS harmonic contentDistorted measurement = wrong relay decisions
Continuous rating basisDeclared at real enclosure ambientE-house internal temperature exceeds site ambient
Spare capacitySpare cubicles and bus rating for expansionStorage sites expand; substations rarely do
Type test reportsFull reports from an accredited laboratoryA certificate number is not a test report
Lead time critical pathRelay model and CT/VT schedule frozen earlyEnclosure is 30-60 days; relays can be far longer

Quoting a Storage Project?

NAIJI Electric builds metal-enclosed and metal-clad MV switchgear, ring main units, vacuum circuit breakers and vacuum contactors from 12 kV to 40.5 kV, with M2 / E2 / C2 classification available and IAC-classified assemblies. Factory direct, typical lead time 30-60 days after drawing approval.

Send us the single-line, the PCS rating and the expected daily cycle count, and we will quote against your actual duty rather than a distribution default. Request a quote or speak to our engineering team.

Frequently Asked Questions

What voltage switchgear is used in a BESS?
Almost all grid-scale battery storage uses medium-voltage switchgear in the 12 kV to 40.5 kV band at the collection level, matching the secondary of the step-up transformer that each power conversion system feeds. Common classes are 12 kV and 24 kV for collection inside the site and 33-36 kV at the point of connection, with 40.5 kV used where the local distribution network runs at that level. The choice is dictated by the utility interconnection voltage and the cable economics of the collector circuit, not by the battery itself — the battery side is DC and is handled by DC breakers and fuses inside the container.
Why does a BESS need different switchgear from a normal distribution feeder?
Two assumptions built into ordinary distribution switchgear break in a BESS. First, operating frequency: a utility feeder breaker may operate a few dozen times a year, whereas a BESS breaker tied to daily or twice-daily transformer energisation plus grid-service dispatch can accumulate 700-1,500 operations a year. IEC 62271-100 mechanical endurance class M1 is only 2,000 operating cycles, so an M1 breaker can be used up inside two years. Second, fault behaviour: a synchronous generator delivers roughly 5-20 times rated current into a fault, while an inverter-based power conversion system is current-limited by its own firmware to about 1.1-1.5 times rated. Overcurrent protection sized on utility assumptions may never pick up on the BESS side of the transformer.
What mechanical and electrical endurance class should BESS switchgear have?
Specify mechanical endurance class M2 and electrical endurance class E2 as a minimum for any breaker in the cycling path, and add restrike class C2 wherever the breaker switches a transformer with a long cable behind it. M2 is 10,000 operating cycles against M1 at 2,000. At an assumed 730 operations a year — one charge start and one discharge start per day — an M1 breaker reaches its rated endurance in under three years, while M2 lasts about thirteen. If the asset is doing frequency regulation or multiple daily arbitrage cycles, count the actual dispatch profile rather than assuming one cycle per day, because that number can double or triple.
What is restrike class C2 and why does it matter for battery storage?
C1 and C2 are the capacitive-switching restrike classes defined in IEC 62271-100: C1 denotes a low probability of restrike and C2 a very low probability, verified by a more demanding type test. It matters in a BESS because the breaker routinely switches an unloaded or lightly loaded step-up transformer sitting behind a long collector cable, which is a capacitive circuit. A restrike on a capacitive circuit traps charge and escalates the voltage across the transformer and the inverter output filter. Given that the same breaker will do this thousands of times over the project life, the difference between C1 and C2 is not academic. C2 costs marginally more at order and is the single cheapest insurance policy on the list.
Does a BESS need arc-flash rated switchgear?
Internal arc classification to IEC 62271-200 is as important in a BESS as anywhere else, and arguably more so because sites are often unstaffed with slow emergency response and are frequently co-located with a large amount of stored chemical energy. Specify an IAC classification with the accessibility types that match how people actually work on the equipment — commonly IAC AFLR, meaning front, lateral and rear accessibility — together with the tested arc current and duration, typically expressed as something like 25 kA for 1 s. Also confirm that the pressure relief path discharges somewhere safe: an arc duct that vents into a walkway or towards the battery containers is a classification on paper and a hazard in practice.
How do harmonics from the inverters affect switchgear selection?
Power conversion systems inject switching-frequency harmonics into the MV network, and the main practical consequence for the switchgear is additional heating in the busbars and current transformers plus accelerated ageing of any capacitive components. Two rules follow. Apply a continuous current derating rather than sizing the busbar exactly at the transformer rating, and specify current transformers with an adequate accuracy class at harmonic frequencies rather than only at 50 or 60 Hz, otherwise protection relays receive a distorted picture of the current they are supposed to be measuring. Where a harmonic filter or capacitor bank is installed at the MV bus, the breaker that switches it carries a genuine capacitive switching duty and needs C2 classification.
What is the typical lead time for MV switchgear on a BESS project?
Factory direct from a Chinese manufacturer, typical production lead time for standard 12-40.5 kV metal-enclosed or metal-clad assemblies is 30-60 days after drawing approval, with drawing approval itself usually taking two to four weeks depending on how quickly the customer returns comments. The critical path on most BESS projects is not the switchgear enclosure — it is the protection relay model, which can have far longer lead times if a specific utility-approved relay is mandated, and the instrument transformers if unusual ratios or accuracy classes are specified. Freeze the relay selection and the CT/VT schedule early and the rest of the package follows comfortably.
